SAP Mass Change
SAP mass change is the practice of updating fields on many existing SAP records in one controlled run from a file, rather than editing each through its transaction. It differs from mass creation in one decisive respect: the value you are about to overwrite belongs to something already in use, and there is no reversal document for a change.
- A change is riskier than a create. A failed create leaves nothing behind; a wrongly successful change silently destroys the previous value.
- The extract is the mechanism, not good practice. It is the only rollback that exists, which is why it is stage one.
- Check that the current value is what you expected. A record that moved since the extract is somebody else's change you are about to discard.
- Organisational level decides your row count. Getting it wrong produces inconsistency rather than failure, which is harder to find.
- Try MM17 or KS12 first. Standard mass maintenance is free and adequate for simple sweeps from a selection screen.
What SAP mass change means
SAP mass change is the practice of updating fields on many existing SAP records in one controlled run from a structured file, rather than editing each through its transaction. It covers material master fields, vendor and customer data, pricing conditions, cost centres and open documents, and it differs from mass creation in one decisive respect: the value you are about to write over belongs to something that is already in use.
This is the second of the three pillars in this cluster. The mass upload pillar covers getting data into SAP; this one covers changing what is already there. They share tooling, file shapes and validation, and they carry entirely different risk.
There is no reversal document for a change. Financial documents have FB08. Goods movements have their reversal movement types. A master data change has neither, and the only route back is writing the previous value, which exists only if somebody kept it.

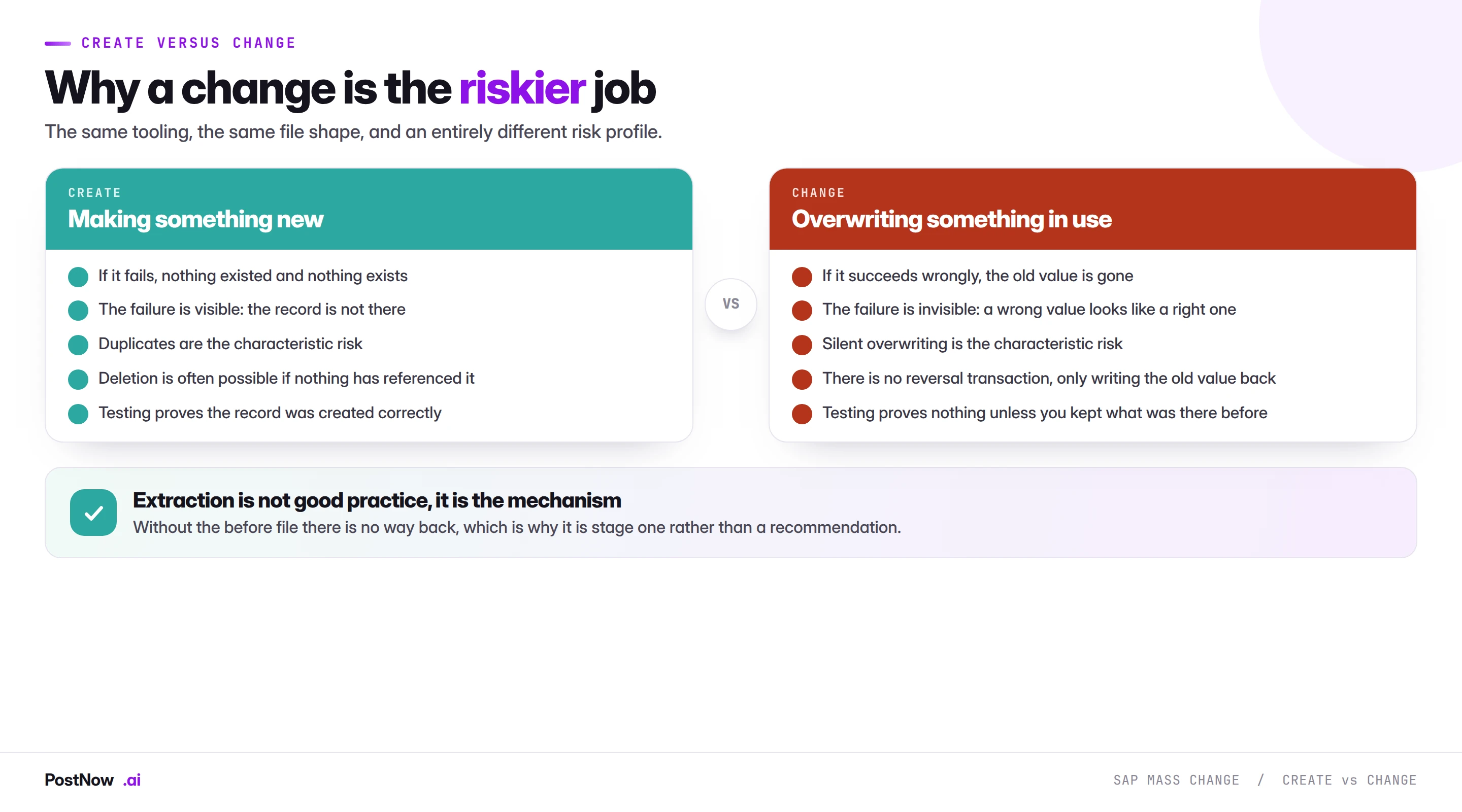

Why a change is riskier than a create

The two jobs look almost identical from the outside. Same file shape, same mapping exercise, same validation tooling. The difference is what happens when they go wrong.
A create that fails leaves nothing behind. The record did not exist before and does not exist now. The failure is visible, because you can look for the record and it is not there. Where a create succeeds wrongly, deletion is often possible provided nothing has referenced it yet.
A change that succeeds wrongly is invisible. The record exists, it looks correct, and it contains a value that is wrong. There is no error, no missing record, and no obvious symptom. The previous value is gone, and unless it was extracted first there is no way to determine what it was.
This asymmetry drives everything else in this guide. It is the reason the extract is stage one rather than a recommendation, the reason validation includes checking the current value, and the reason mass change deserves more testing than mass creation despite feeling like the smaller job.

The extract is the mechanism, not good practice
Pull the current value of every field you intend to touch, for every record in scope, before building the change file. Keep it as a column beside the new value rather than as a separate document.
It does four jobs at once, and each would justify the step on its own.
- It is the rollback. Posting the old column back restores the previous state. Without it, restoration means reconstructing values from memory or from a backup nobody wants to restore.
- It validates scope. If the extract returns three thousand nine hundred rows and the request said four thousand records, the difference is worth understanding before the change rather than after.
- It reveals the unexpected. Records already holding the target value, records whose current value nobody predicted, records where the segment does not exist. All cheaper to handle before the run.
- It is the audit evidence. Before and after in one artefact, produced by the person who ran the change. This is a better review object than the change documents it produces, because it shows intent alongside outcome.
Extracts go stale
Between extracting and writing, other people are working. A record whose current value has moved since the extract is a record where somebody else made a change, and overwriting it silently discards their work.
This is why the validation list on this page includes a check that the current value matches what the file expected. It is the check most often skipped and the only one that detects a collision. On a long-running programme where extraction and writing are days apart, it stops being optional.

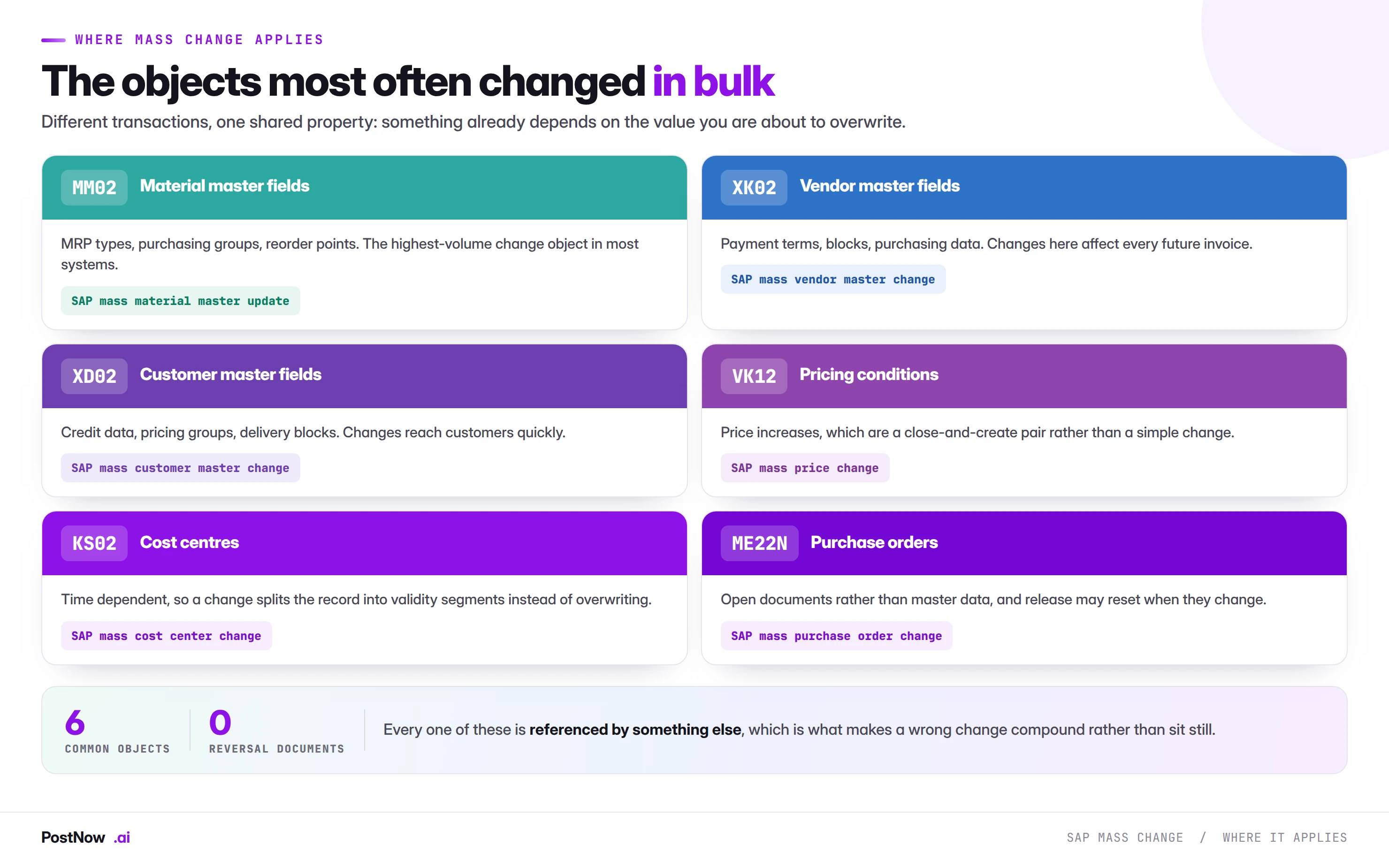

Where mass change applies

The objects differ, and the shared property is that something already depends on the value being overwritten. That is what makes a wrong change compound rather than sit still, and it is covered in more depth on the master data bridge.
Three of these behave differently enough to note.
Pricing conditions are not really a change. A price increase is a close-and-create pair: end the existing record the day before the new one starts, then create the new one. Files built as pure changes produce overlapping validity and ambiguous prices. The pricing guide covers why.
Cost centres split rather than overwrite. Time-dependent objects create a new validity segment when a field changes, so the old value remains valid for the earlier period. This is useful and it means a correction intended to apply from January must be dated January, not today. The cost centre guide covers the mechanics.
Open documents are not master data. Changing a purchase order or sales order may reset a release, re-trigger determination, or be blocked entirely once a subsequent document exists. These are changes to things in flight rather than to reference data, and the constraints are different.

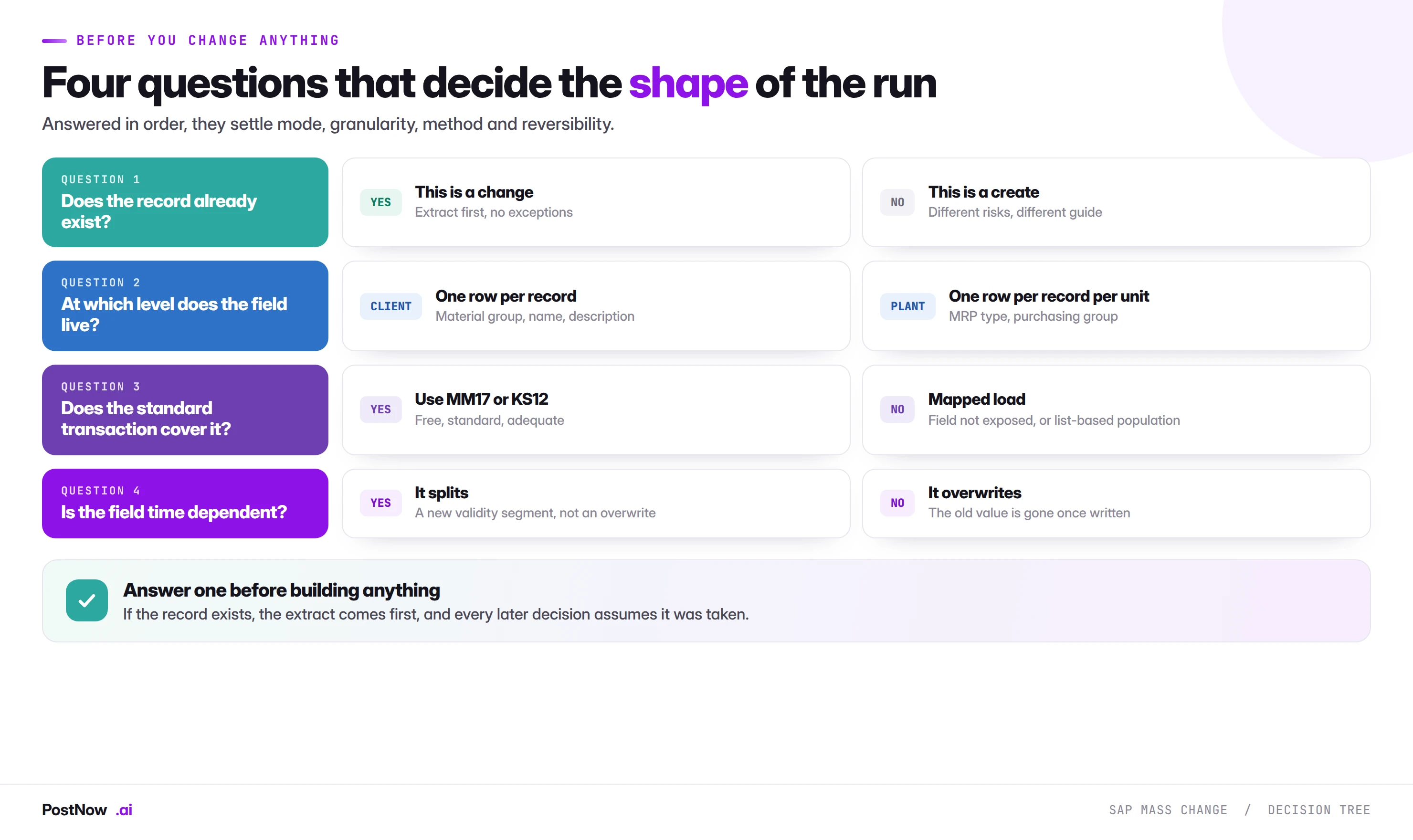

Granularity: the error that produces no error
The most common structural mistake in mass change work is a file whose row count does not match the organisational level of the field being changed.
A client-level field needs one row per record. A plant-level field needs one row per record per plant. A sales area field needs one row per record per sales area. Get this wrong and there is no error message: the change lands in the organisational units your file covered and not in the others.
The result is inconsistency rather than failure, which is worse. Planning behaves differently at different sites. Pricing differs by sales area for no discernible reason. Nobody links the symptom back to a load that reported complete success weeks earlier.
The question to ask before building any change file is simply: at which organisational level does this field live? If the answer is not immediately obvious, the row count is probably wrong.

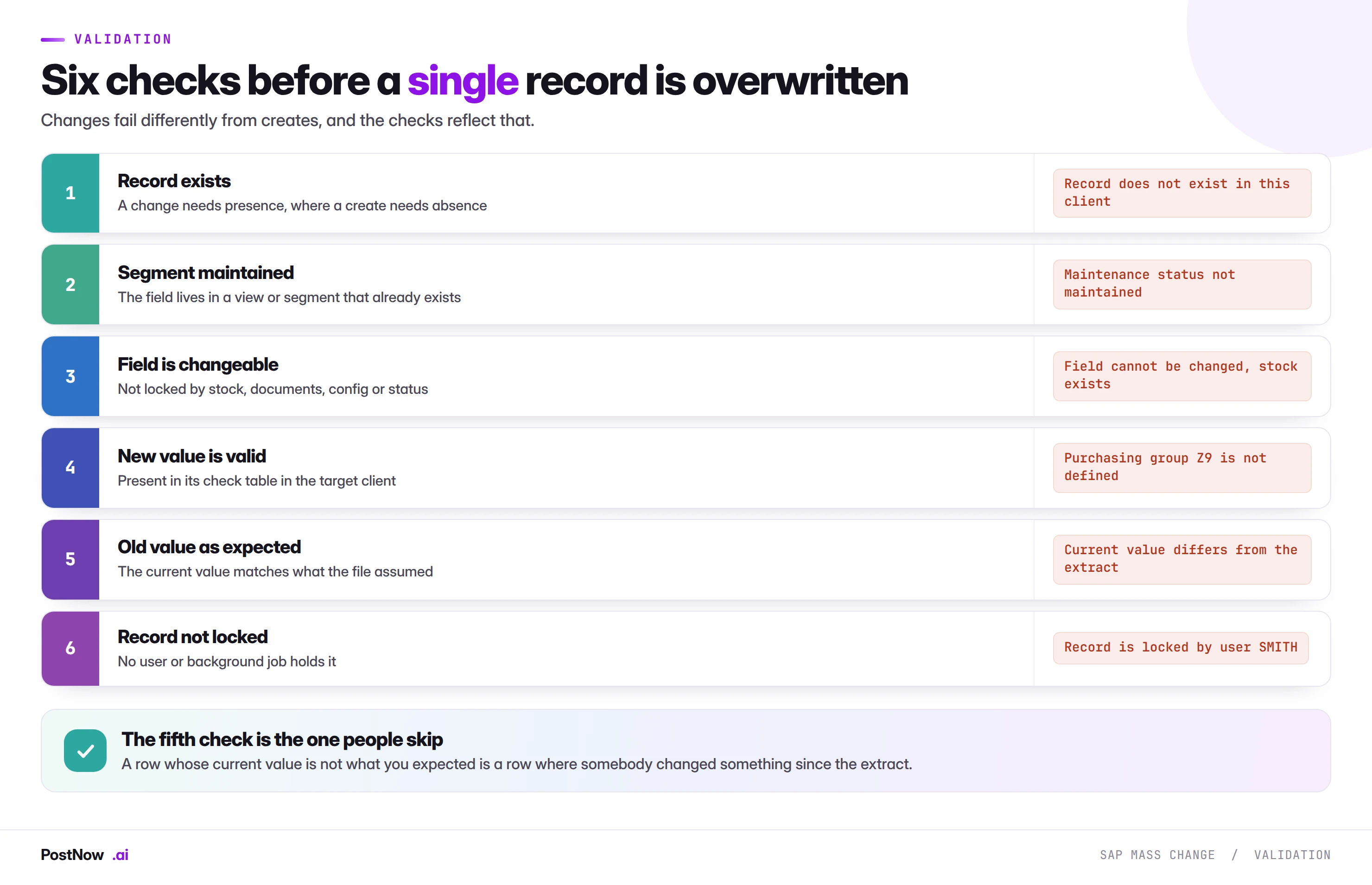

Validation for changes

Two of these deserve expanding because they have no equivalent in a create run.
Is the field changeable? Fields lock for reasons that have nothing to do with authorisation. Base unit of measure locks once stock or documents exist. Valuation-relevant fields lock depending on period status. Material type is not a field change at all but a conversion. A file assuming every field is open will fail on the subset that is not, and the message names the field rather than explaining the dependency.
Is the old value what you expected? The collision check described above. It costs one extra comparison and it is the only thing standing between a long-running programme and silently discarding somebody else's work.

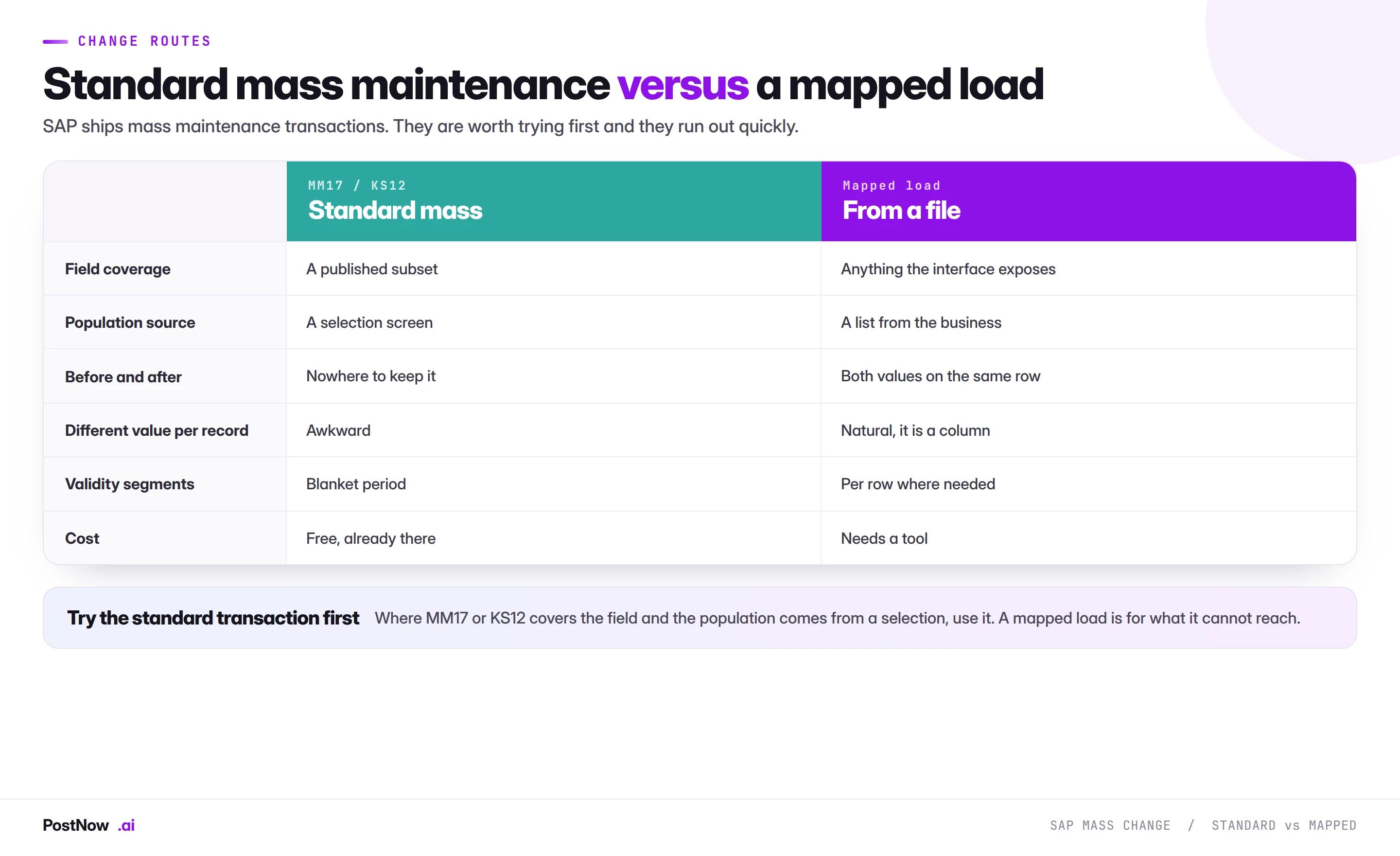

Standard mass maintenance versus a mapped load

SAP ships mass maintenance transactions, and they deserve a fair hearing before anyone reaches for a tool. MM17 for material master, KS12 for cost centres, and their equivalents elsewhere are free, standard, and adequate for a large share of simple sweeps.
They run out in four recognisable situations.
- The field is not exposed. Coverage is a published subset rather than everything, and the field you need is often outside it.
- The population comes from a list. Selection screens are built for criteria, not for four thousand record numbers supplied by the business.
- Each record needs a different value. A blanket change is natural in a selection screen; a per-record value is natural in a column.
- You need the before-and-after. There is nowhere in a standard mass transaction to keep the previous value, which means no rollback and no audit artefact.
The honest position is that these are complementary rather than competing. Try the standard transaction. Where it covers the field and the population comes from a selection, use it and save the effort.
Running mass changes from Excel
PostNow runs SAP mass change from Excel
Extraction and writing happen in one workbook, which is what keeps the old value beside the new one. PostNow adds a task pane to Excel, connects to your SAP system with your own credentials, and takes the file through extraction, mapping, validation and writing without leaving the sheet.
Current values pulled into the sheet before anything is overwritten.
Old and new side by side, so the change is reviewable and reversible.
Existence, segments, changeability and check tables against live SAP.
Through the published interface, so change documents are produced as normal.

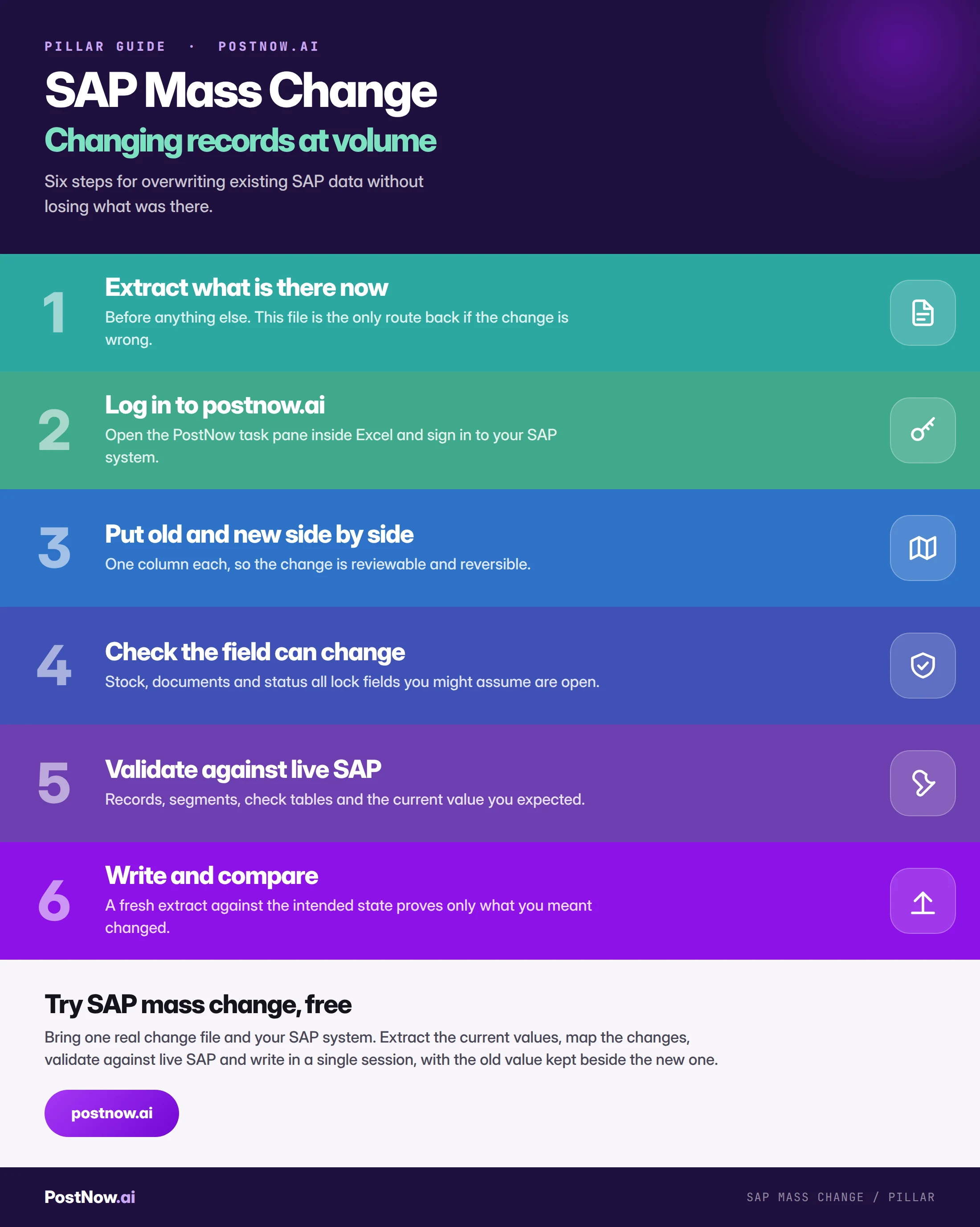

SAP mass change, step by step

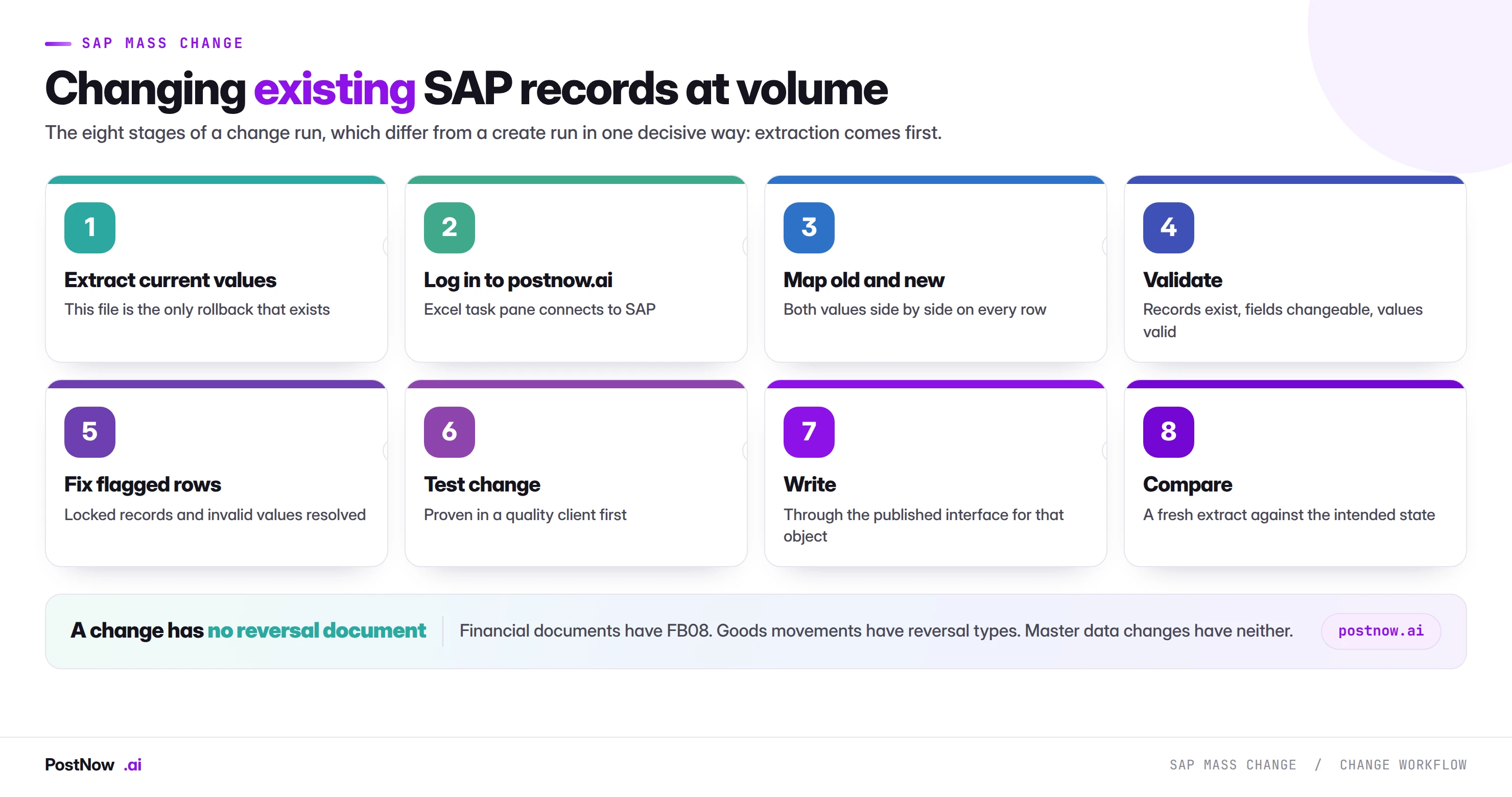

Reversing a mass change
Because there is no reversal transaction, reversal is another mass change with the columns swapped. That is straightforward when the extract exists and impossible when it does not, which is the entire argument of this guide in one sentence.
Three practical points if you find yourself doing it.
Reverse from the extract, not from memory. The extract is a factual record of the previous state. Reconstructing values from a specification, an email or somebody's recollection introduces a second error on top of the first.
Reverse the whole population, not the subset you noticed. If a change was wrong, it was wrong for every row it touched, not only the rows somebody complained about.
Expect the change documents to show both. The wrong change and its correction both appear in the record. That is correct and it is worth telling whoever reviews it, because a change document trail showing a value moved and moved back invites a question.
Where the change is time-dependent, reversal is different again: rather than restoring a value, you are correcting a validity segment, and the object guides cover the specifics.
Scoping a change: the population is the decision
Most of the risk in a mass change is settled before any file is built, when somebody decides which records are in scope. That decision is usually made by describing a criterion rather than listing records, and the gap between the two is where trouble starts.
"Change the MRP type for all raw materials in the European plants" sounds precise. It resolves to a population that depends on how material type is assigned, which plants count as European, whether discontinued materials are included, and whether the person asking meant materials currently in use or every record ever created.
Three practices close that gap.
- Resolve the criterion to a list, then show it back. The extract does this for free. Sending the count and a sample to whoever requested the change catches scope misunderstandings before anything is written.
- Report the records already correct separately. If two thousand of four thousand already hold the target value, the scope was probably drawn wider than intended, and that is worth a conversation rather than a silent adjustment.
- Ask what should happen to the edge cases explicitly. Blocked materials, records with no value in the field, records in plants being decommissioned. Every population has them, and deciding by default is how unintended changes happen.
The pattern to avoid is scope arriving as a sentence and being resolved by whoever builds the file. That places a business decision with the person least equipped to make it, under time pressure, with no record that a decision was made at all.
Phasing a large change programme
Where a change touches thousands of records across several objects, running it as one event is usually worse than running it in phases, for reasons that have little to do with system capacity.
Phase by blast radius, not by convenience. Start with the records where a mistake is cheapest: a non-critical plant, a low-volume product group, an entity that is not mid-close. Confirm the outcome before extending.
Leave a gap for symptoms to appear. Master data errors surface indirectly and slowly. A change made on Monday that produces odd planning behaviour shows up on the next MRP run, not immediately. Phasing with no gap between waves removes the only chance to catch a systematic error before it reaches everything.
Keep each phase independently reversible. Which means a separate extract per phase rather than one extract covering everything, so a rollback affects only the wave that went wrong.
Re-extract between phases. The world moves. A population extracted at the start of a six-week programme is stale by the final wave.
The counter-argument is real: phasing means the estate is temporarily inconsistent, with some records changed and others not. That is acceptable for most parameter changes and unacceptable where the field drives a process that spans the population. Decide which case you are in before choosing.
Governance for changes
Changes attract more scrutiny than creates in most governance frameworks, and reasonably so.
- Approve the file with both columns. Old value and new value on the same row is the reviewable artefact, and it is reviewable in minutes rather than requiring four thousand individual approvals.
- Show the count of records already correct. A large number usually means the scope was drawn too wide, and changing a field to the value it already holds adds noise to the change log without changing anything.
- Run as a named user. With that person's authorisations, so the change can only touch what they could already maintain.
- Keep the extract with the change request. It is simultaneously the rollback and the evidence.
- Reconcile afterwards. A fresh extract compared to the intended state, confirming that what changed is what was meant to change and nothing else moved.
- Change documents are written as normal. Worth saying early, because it is the first question asked and the answer usually shortens the conversation.
Volume, locks, and timing
- Lock contention drives the failure rate. Changes touch records people are using, more than creates do. Schedule outside working hours for large populations and design for a second pass.
- Row counts multiply by organisational level. Records times plants times segments grows fast, and a request for four hundred changes can be twenty thousand rows.
- Batch by organisational unit. Homogeneous failure modes and a batch you can describe in one sentence.
- Avoid running against a planning or costing run. Both hold records and both produce lock errors that look like data problems.
- Mind the gap between extract and write. The longer it is, the more likely a collision, which is what the current-value check is for.
Mistakes specific to mass change
- Running without extracting first. The only mistake in this cluster that cannot be undone.
- Mismatching row count to organisational level. Produces inconsistency rather than failure, which is harder to find.
- Assuming the segment exists. A change updates a view or segment and never creates one.
- Skipping the current-value check. Silently discards changes other people made after your extract.
- Changing fields already holding the target value. Harmless individually, and it fills the change log with noise that hides the changes that mattered.
- Treating a price change as a simple change. It is a close and a create, and treating it otherwise produces overlapping validity.
- Reaching for a tool before trying MM17 or KS12. Where the standard transaction covers the field, it is free and adequate.
- Testing less than you would for a create. The risk runs the other way.
Change guides by object
- SAP mass material master update (MM02). The highest-volume change object, with view structure and plant-level granularity.
- SAP mass pricing condition upload (VK11). Why a price change is a close and a create rather than an update.
- SAP mass cost center creation (KS01). Time dependency, where a change splits the record into validity segments.
- SAP master data mass upload. The bridge covering create, change and extend across all master data objects.
- SAP data upload methods. Which mechanism to use, and why two of the six are never acceptable.
Who owns a change
Change ownership is where most of the friction sits, because the person requesting a change, the person executing it and the person affected by it are usually three different people who never meet.
The requester owns the intent. What should change, for which records, and why. This is domain knowledge and it should arrive as a written scope rather than a conversation.
The operator owns the execution. Mode, granularity, validation and whether the extract was taken. These are technical decisions, and the one that matters most is the one nobody sees: whether a rollback exists.
The affected function owns the consequence. Planning lives with an MRP type change. Accounts payable lives with a payment terms change. They are rarely consulted and always the first to notice.
The step that closes this is small and routinely skipped: tell the affected function before the change, not after. One message describing what is changing and when converts a mysterious behavioural shift into an expected one, and it is the difference between a process improvement and a support ticket.
What S/4HANA changes for mass change work
The conversion affects change work less than creation work, because the objects being changed largely survive intact. Four things are worth knowing.
Business Partner affects vendor and customer changes. Where XK02 and XD02 were the change transactions on ECC, S/4HANA routes both through the Business Partner object with roles. The fields are largely the same and the access path differs, so a mapped change needs a remap rather than a redesign.
Extended field lengths matter more for changes than creates. A change file carrying a material number truncated to the ECC length will not match records created at the extended length, and the failure reads as though the record does not exist.
The universal journal widens the blast radius. A cost centre or profit centre assignment change now affects a single record used by both finance and controlling reporting rather than two reconciled views, so a structural mistake shows up in more places.
Interfaces carry forward; recordings do not. The same argument that appears throughout this cluster, and it applies with particular force to change processes because they tend to be long-lived. A monthly change built on a recording will be rebuilt during a conversion. One built on a published interface will be remapped.
Where a conversion is on the roadmap, the practical implication is to move recurring change processes onto interfaces before rather than after, since the mapping work is the same and it only has to be done once.
The change requests that keep coming back
Mass change requests are more predictable than they feel. Across most organisations they cluster into a handful of recurring patterns, and recognising which one you have tells you most of what the run needs.
The parameter sweep. Planning or purchasing tunes a setting across a product family: MRP type, lot size, reorder point, safety stock. Plant-level, high row count, low individual risk and high aggregate impact because it changes what the next planning run proposes.
The reassignment. Responsibility moves between people or teams, so purchasing groups, cost centre owners or sales representatives change across a population. Client or organisational level, low risk, and usually urgent because somebody has already left.
The remediation. A governance review produces a list of records with wrong or missing values. Mixed levels, mixed fields, and the population arrives as an exception report rather than a clean criterion, which makes scoping the hard part.
The harmonisation. Two entities merge, or a conversion approaches, and values must be aligned across a population that was maintained independently. Highest risk of the four, because the correct target value is itself a decision rather than a given.
The correction. A previous load was wrong. Smallest population, highest urgency, and the one where the extract from the original run is worth more than anything else you have.
The practical value of naming these is that each has a predictable shape. A parameter sweep needs granularity attention. A remediation needs scoping attention. A harmonisation needs a decision from the business before anything technical starts. Knowing which you have prevents applying the wrong care to the wrong risk.
After a mass change
Because the symptoms of a wrong change appear late and indirectly, the checks immediately after a run are the only cheap opportunity to catch one.
Take a fresh extract and diff it. Not a spot check. Compare the whole population against the intended state, field by field. This catches rows that did not change, rows that changed to the wrong value, and any field that moved when it should not have.
Open three records and read them. Different plants, different value types. A diff confirms the field holds what you intended; reading the record confirms the record still makes sense as a whole.
Check the count of unchanged rows. Rows that were already correct, rows that failed on locks, and rows that silently did nothing all show up here, and the third category is the one worth chasing.
Keep the extract with the request. It is the rollback for as long as the change might need reversing, which is usually longer than anyone expects.
Tell the affected function it has happened. Planning, purchasing or whoever lives with the field. One message, sent the same day, converts an unexplained behavioural change next week into an expected one.

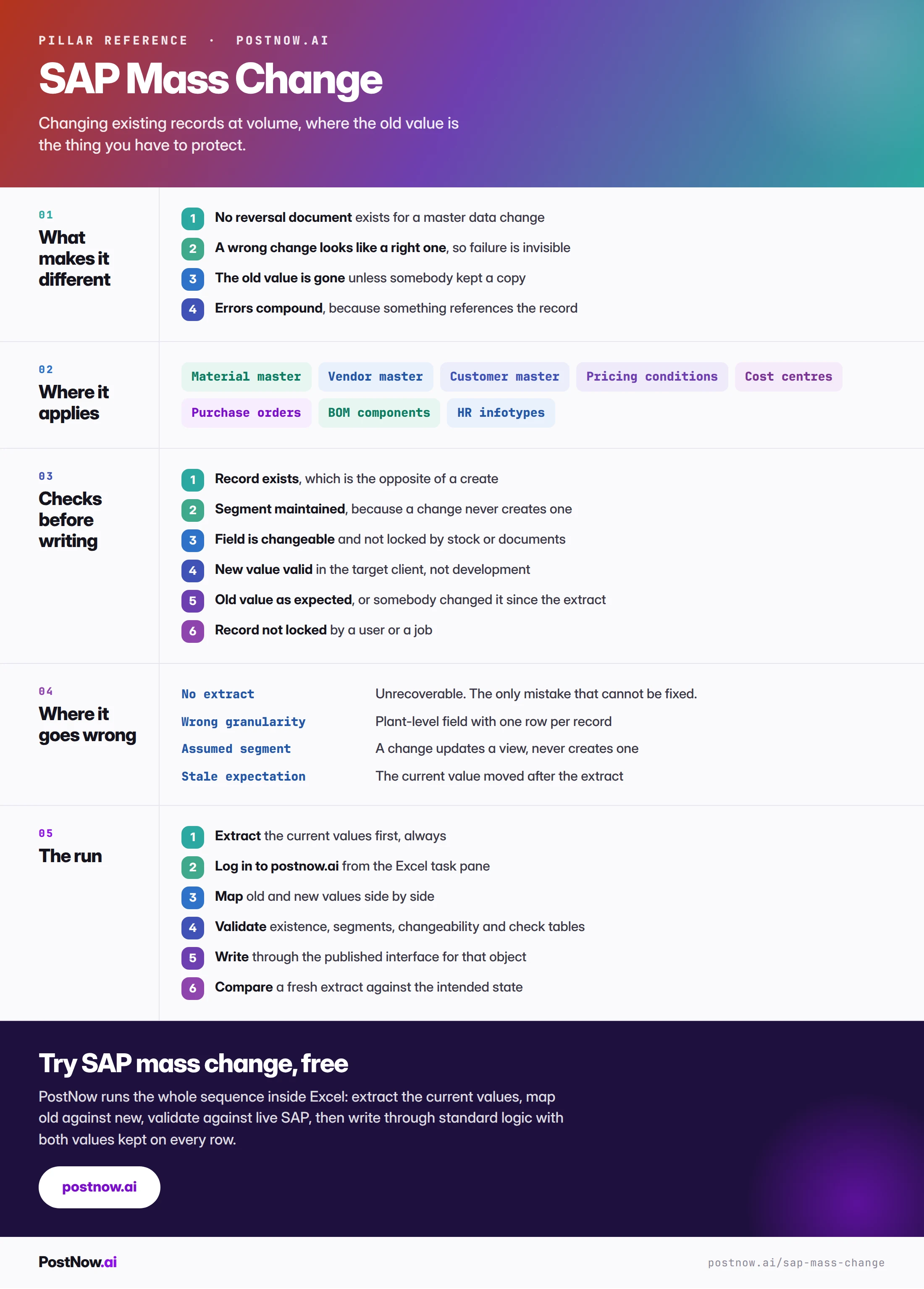

The complete mass change reference
